Munster Legacy Plant Demolition

Demolition

Project overview

Client

Adelaide Brighton Limited, Cockburn Cement Limited

Location

Munster

Service

Top-down demolition and removal of slurry bottles and ancillary plant structures

Unique attributes

Shortlisted:
Contract of the Year under US$1 million – World Demolition Awards 2022

SCOPE OF WORKS

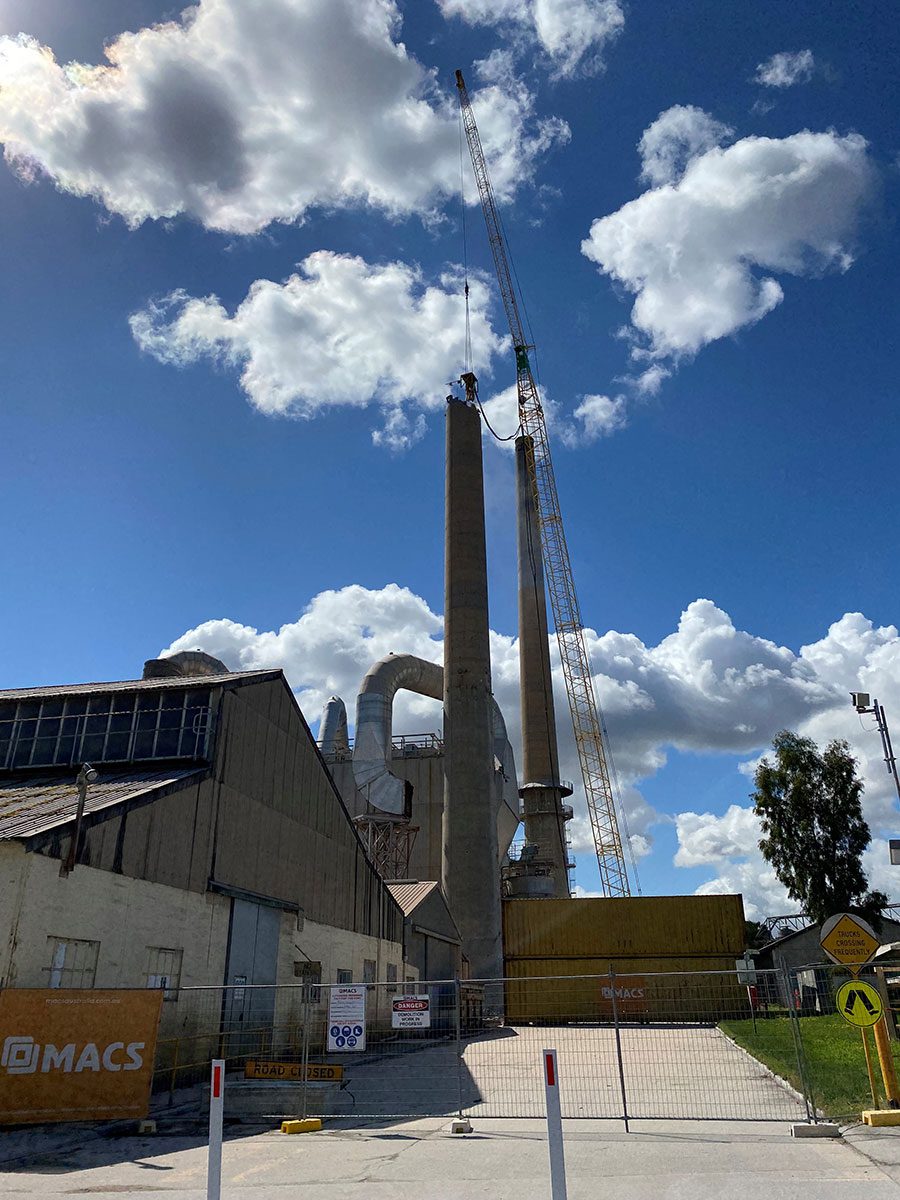

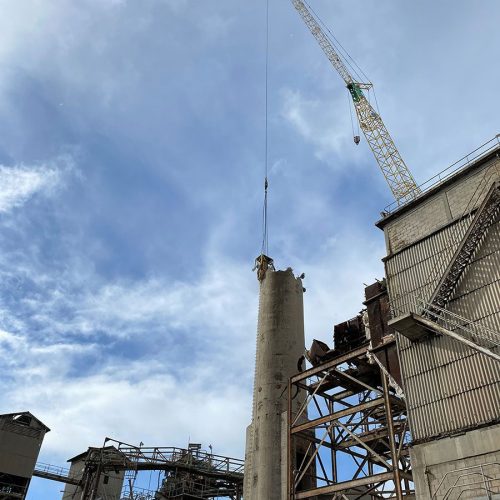

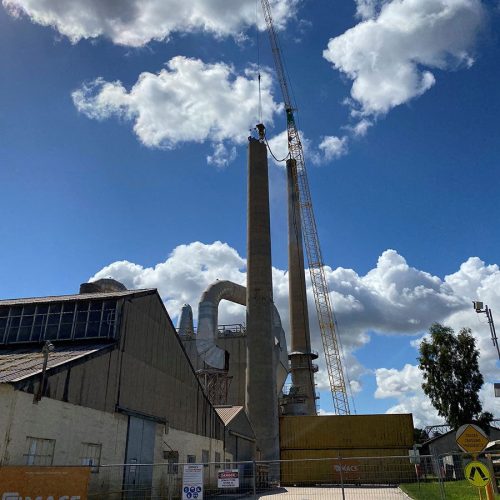

  • Demolition of Kiln Stack 2 (62m in height)

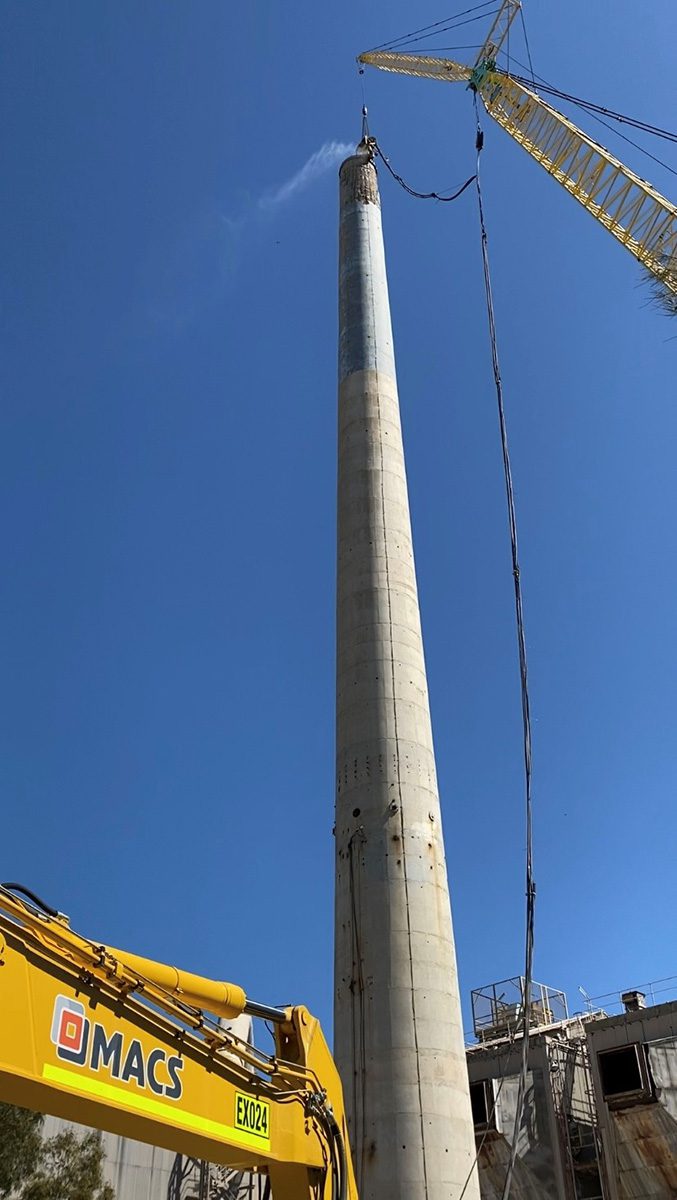

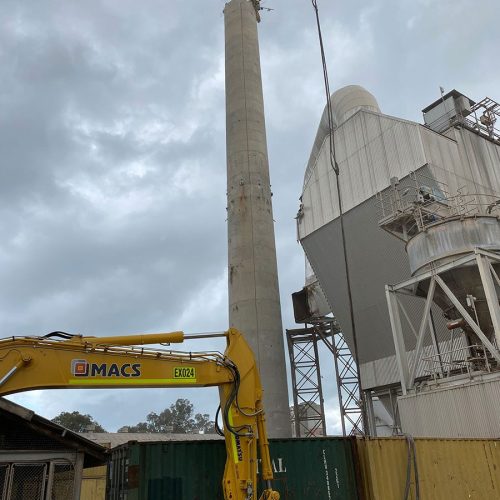

  • Demolition of Kiln Stack 3 (64m in height)

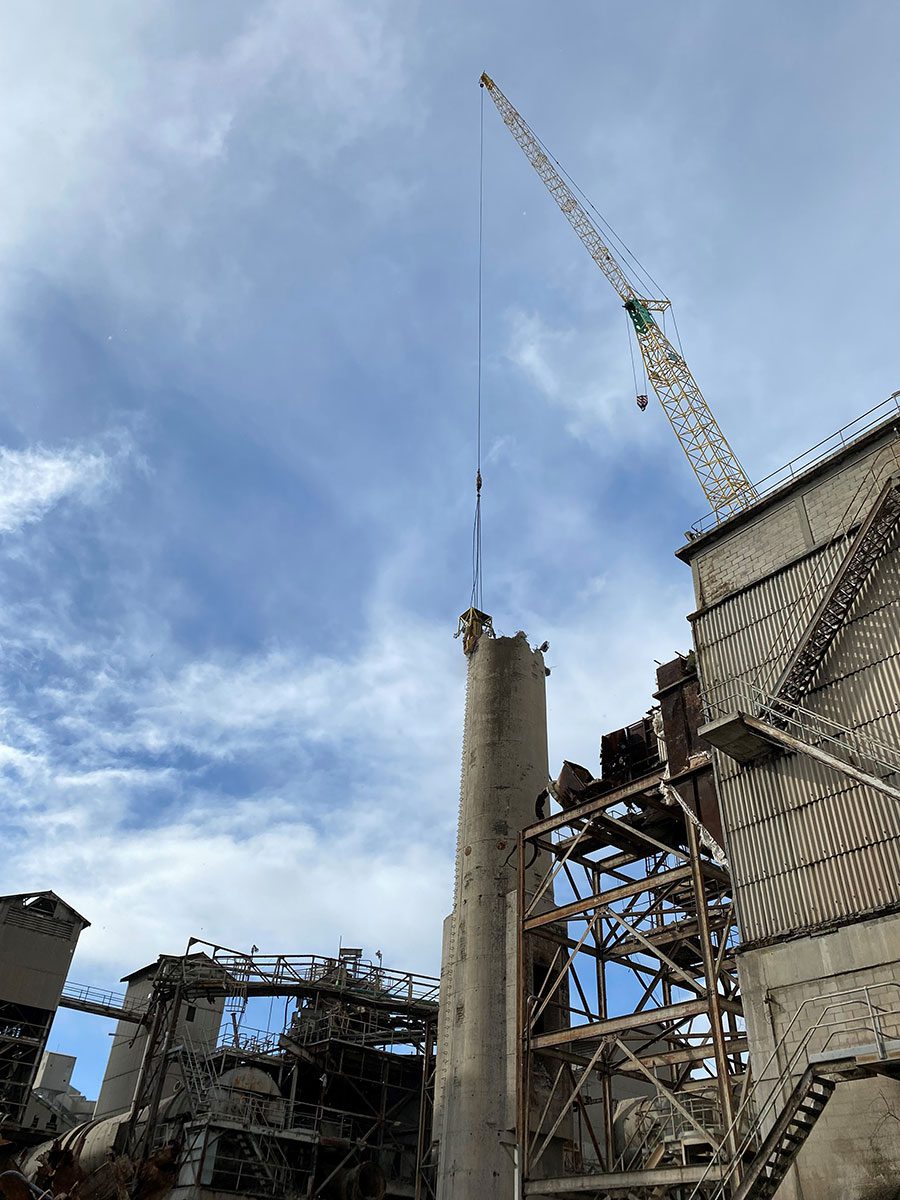

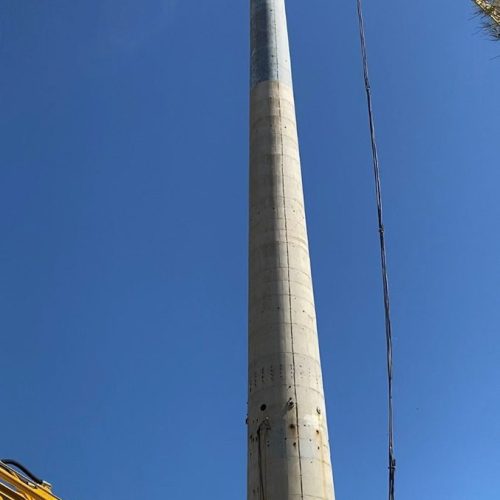

  • Demolition of Kiln Stack 4 (84m in height)

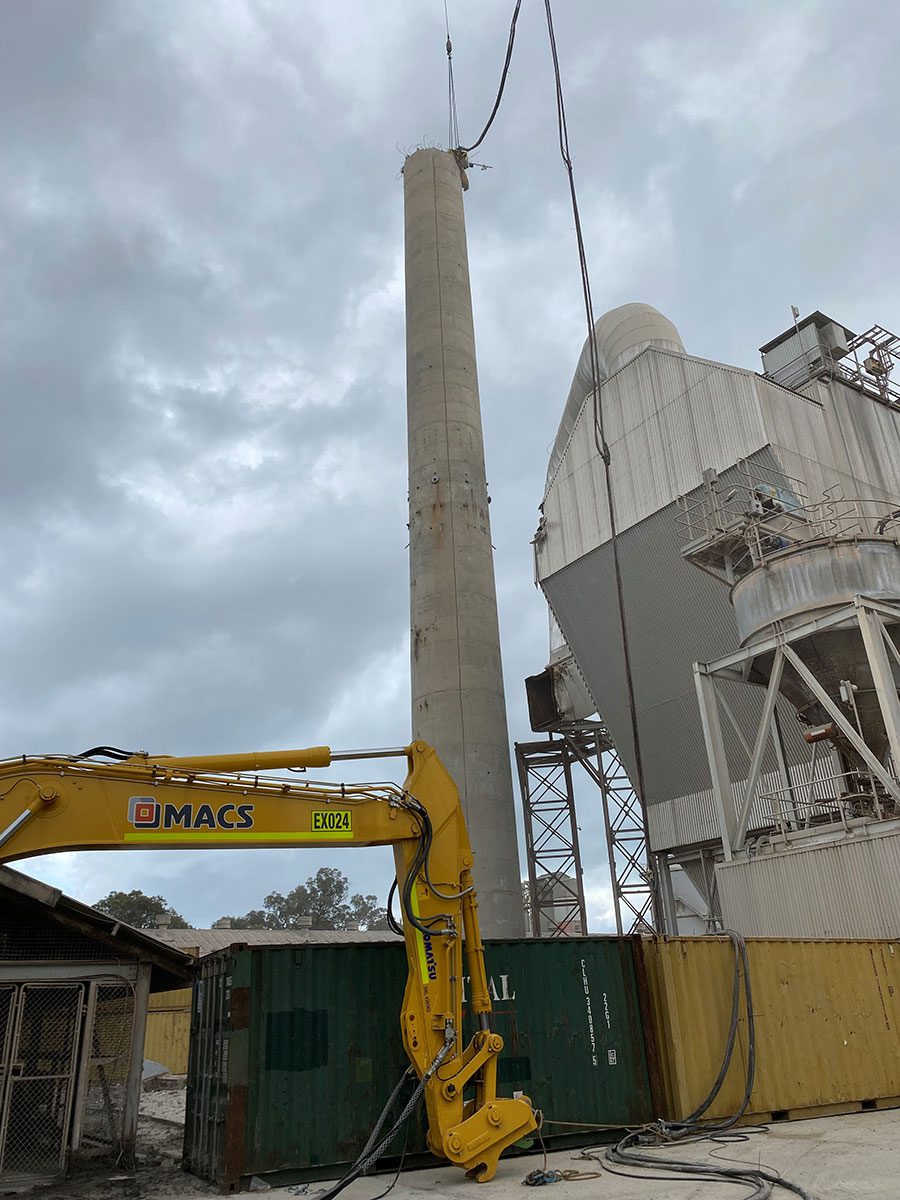

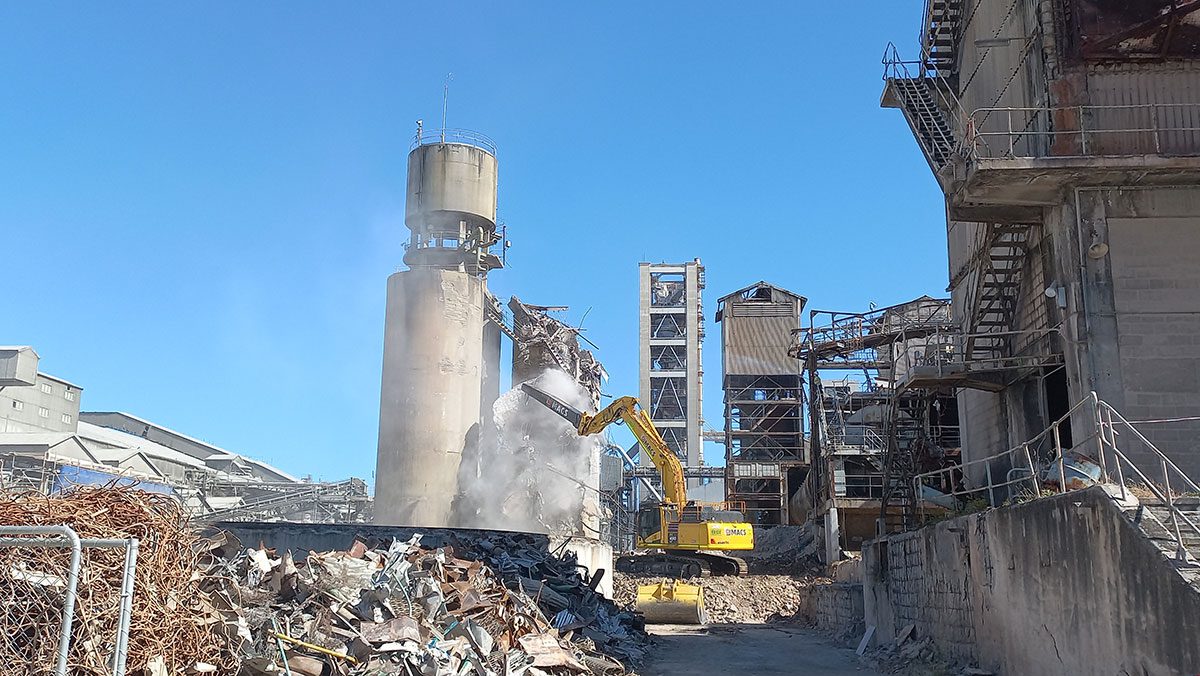

  • Demolition of Slurry Bottles and associated infrastructure

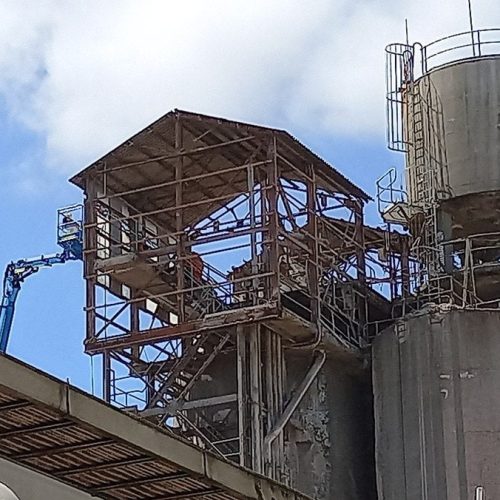

  • Demolition of other redundant plant infrastructure onsite

KEY CHALLENGES

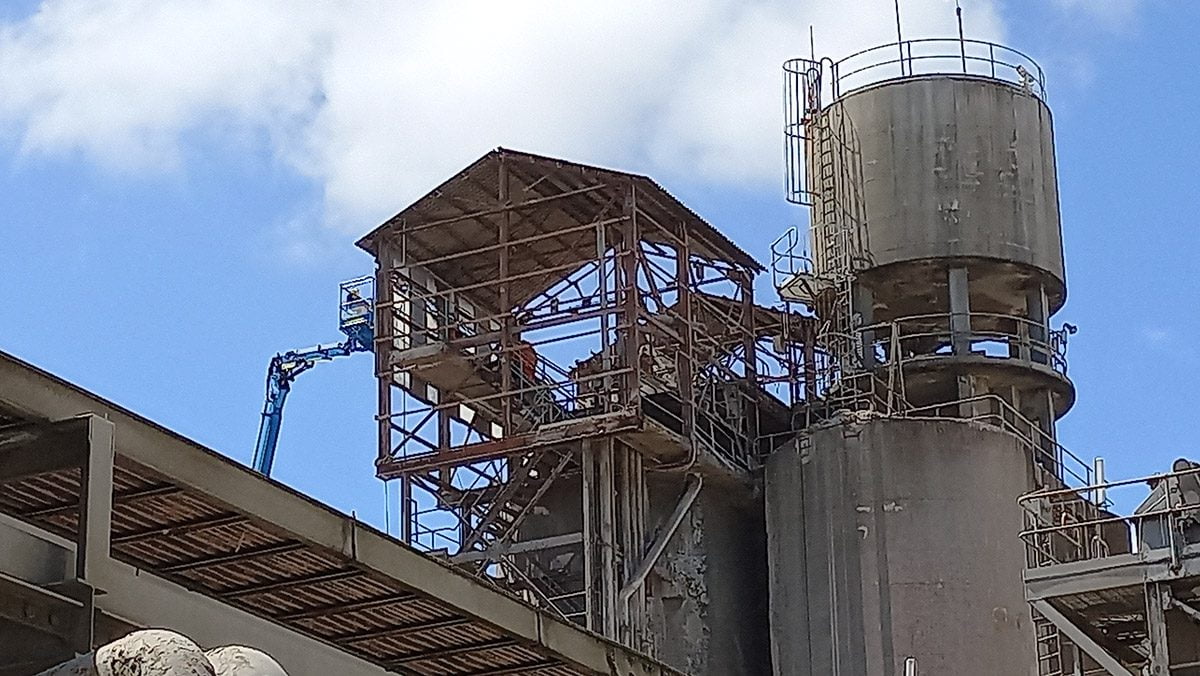

  • Deteriorated Plant
  • Extensive Working at Heights
  • Community Engagement
  • Neighbouring residents
  • Live Train Line
  • Live Plant Operations

Key outputs

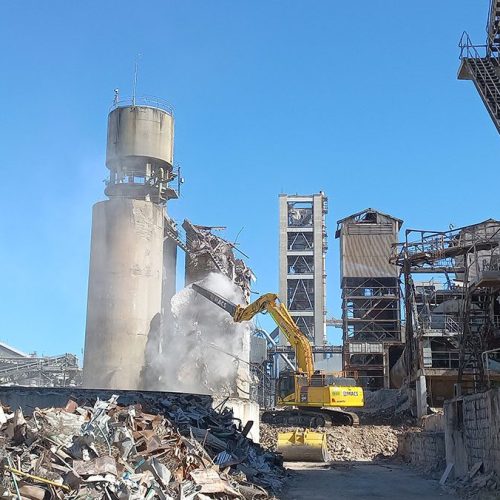

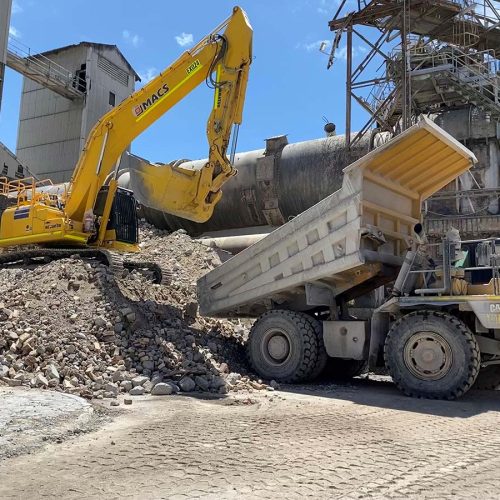

  • Running from August to December 2021, over 400T of steel was processed and recycled, and over 4,000T of rubble was reused onsite.

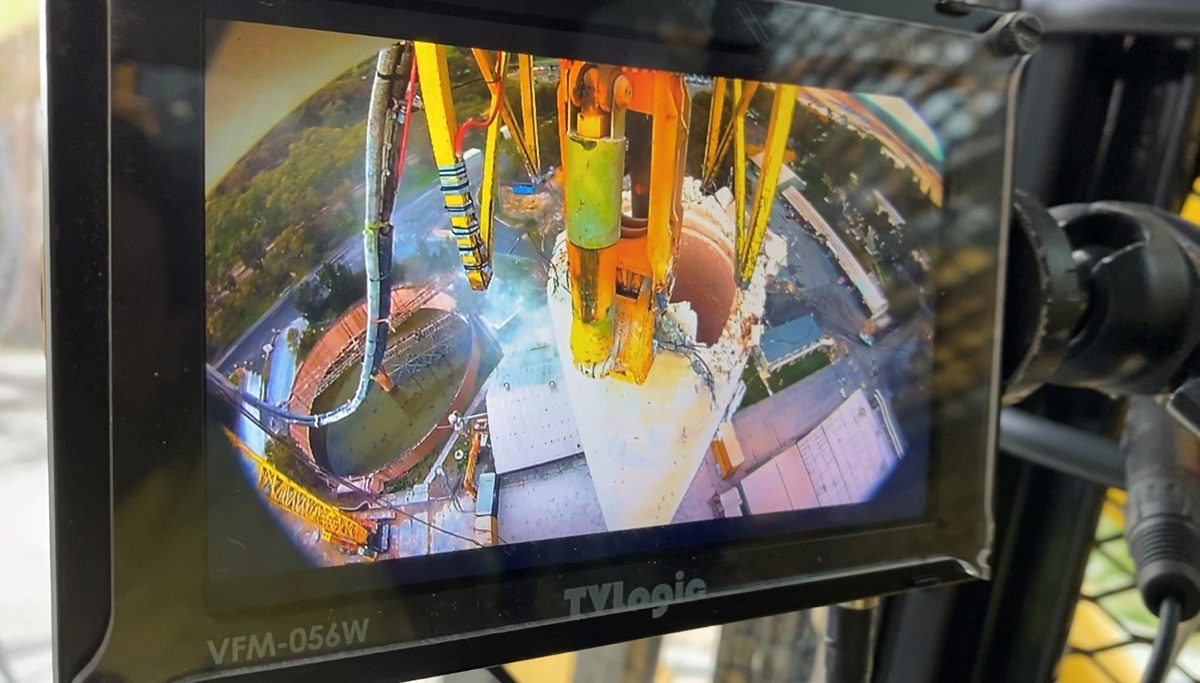

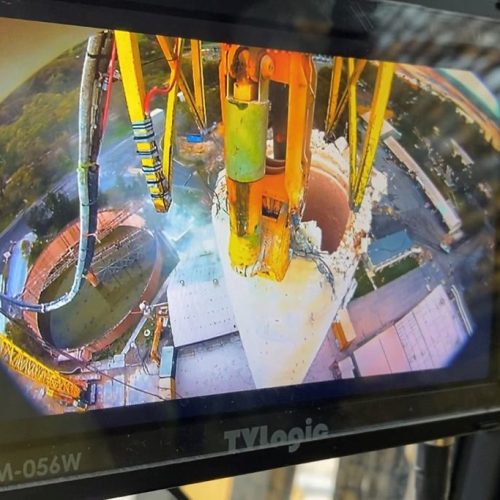

  • A camera system using a low latency 5.8GHZ link provided real time video connection to weatherproof cameras mounted on the pulveriser.

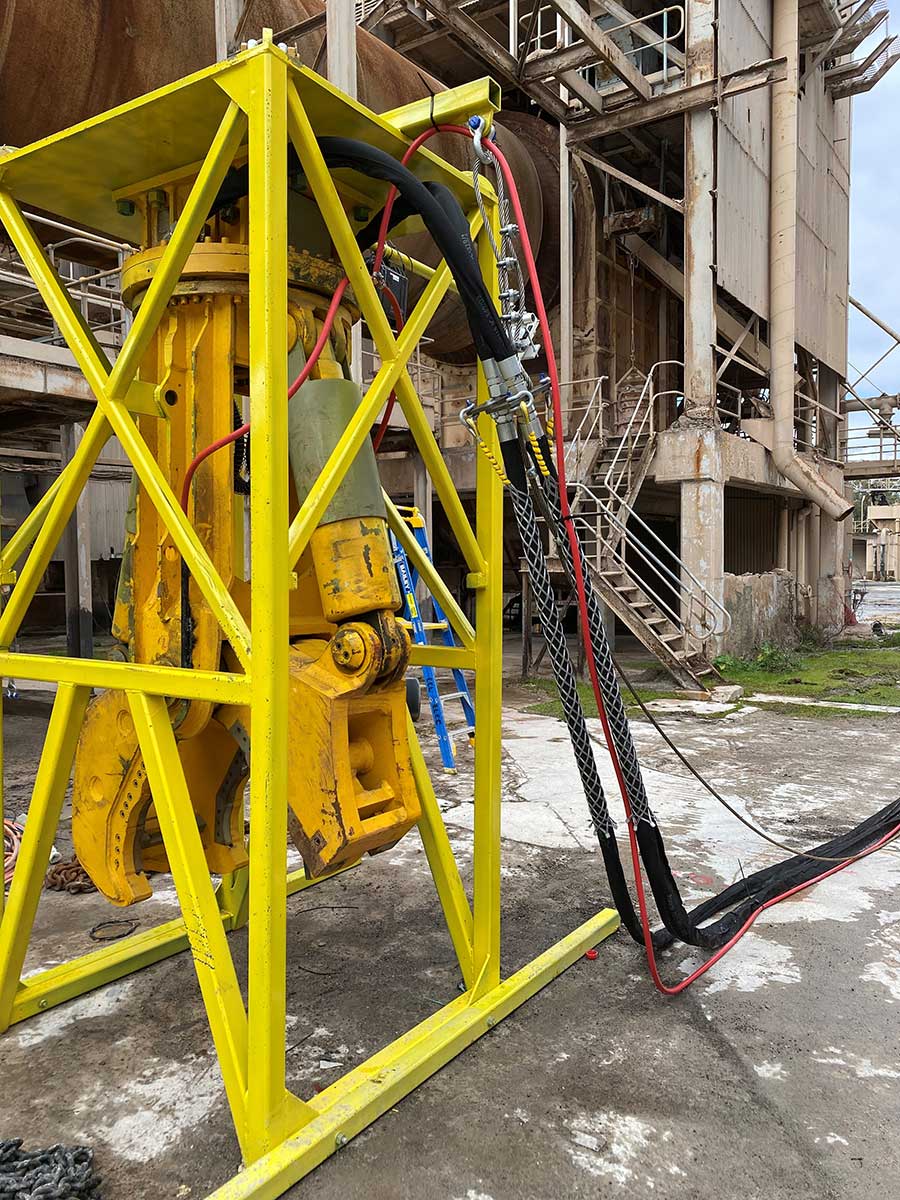

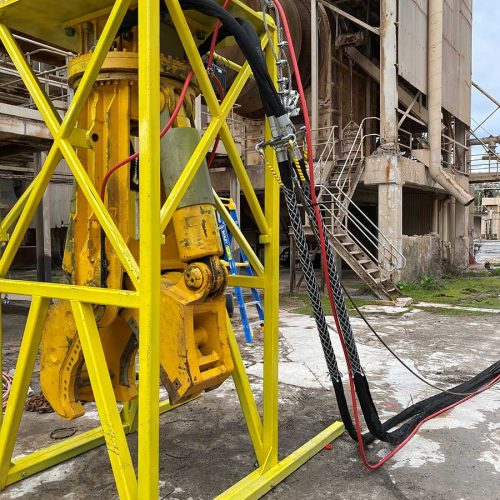

  • The purpose-built pulveriser attachment was suspended by a 275T crawler crane had had 155T of cutting force and required minimum 5,075 PSI of operating pressure.

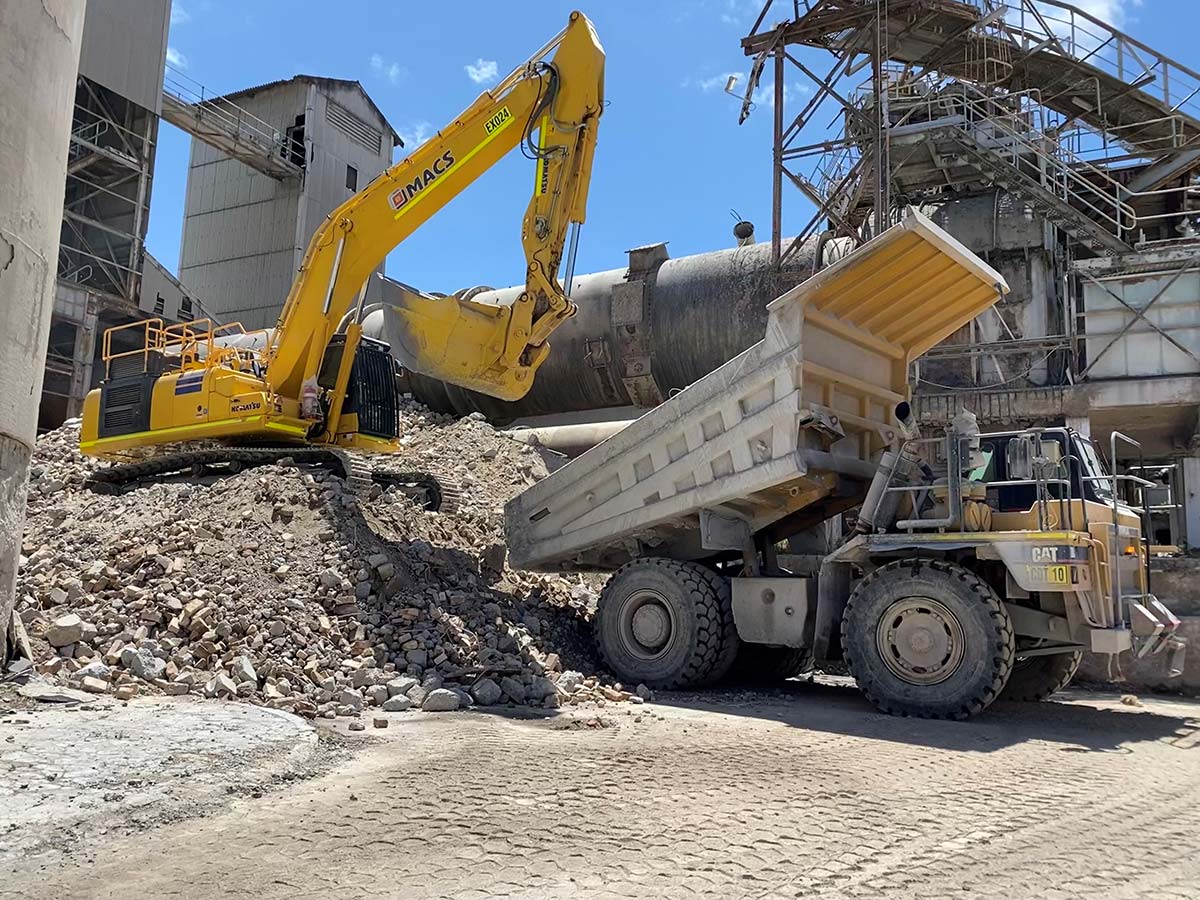

  • A specialised Komatsu PC490 demolition excavator provided power to the pulveriser through 100+m of hydraulic lines, allowing operators to remain outside the line of fire.
  • The demolition area was adjacent to live plant, within meters of a rail corridor and residents.

Gallery

Our priorities are health and safety excellence, local community engagement and environmental responsibility
